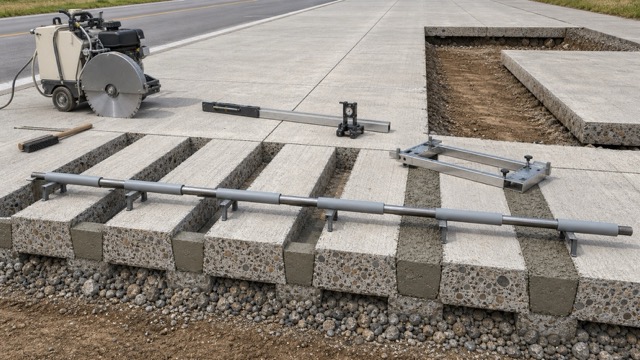

Dowel Bar Retrofit (DBR): Adding Load Transfer to Existing Pavements
A concrete highway built without dowel bars in the 1970s and 1980s is now showing its age. Joint faulting has reached 5–8mm. Corner cracks have appeared at 30–40% of joints. Load transfer efficiency has dropped below 50%. The pavement still functions, but ride quality has deteriorated and maintenance costs are climbing. The owner faces a difficult choice: full pavement reconstruction, or some form of rehabilitation.
For pavements where the slabs are still structurally sound but joint performance has degraded, the answer is increasingly Dowel Bar Retrofit (DBR) — the addition of dowel bars to existing concrete pavement joints to restore proper load transfer. DBR is one of the most cost-effective concrete pavement rehabilitation techniques developed in the last 40 years. It can extend pavement service life by 15–25 years at roughly 25–35% the cost of full reconstruction.
This guide covers the DBR process step-by-step, the specifications for slot cutting and dowel placement, the FHWA-developed standards governing DBR, and the project-economic conditions that determine when DBR makes sense versus full reconstruction.
What Is Dowel Bar Retrofit?
Dowel bar retrofit is a pavement rehabilitation technique that adds dowel bars to the transverse contraction joints of existing concrete pavement that was originally constructed without dowels (or with damaged dowels). The retrofit installs new dowels into saw-cut slots in the existing pavement, oriented to span across the joint and provide load transfer between adjacent slabs.
The process restores joint load transfer efficiency from a degraded state (often <50% LTE) to a good state (typically 75–85% LTE), preventing further joint faulting and extending pavement service life.
DBR is fundamentally different from new pavement construction:
New construction: Dowels are placed in fresh concrete via baskets or DBI
DBR: Dowels are placed in existing hardened concrete via saw-cut slots and rapid-setting backfill
The materials and specifications are similar (often identical dowel bars), but the installation procedure is entirely different.
When DBR Makes Economic Sense
DBR is not a universal solution. It works best when specific pavement conditions are met:
DBR Is Appropriate When:
1. Slabs are structurally sound — the concrete is not extensively cracked, no corner breaks at most joints, no widespread structural failure. The pavement has good fundamental integrity, just degraded joint performance.
2. Joint faulting is moderate — 3–8mm faulting at affected joints. Above 10mm faulting, the pavement may have other underlying issues (subbase failure, voiding) that DBR alone cannot fix.
3. Pavement has significant remaining service life — at least 15+ years of expected service life if joint problems are addressed. DBR is not appropriate for pavements approaching the end of their structural life.
4. Traffic disruption from full reconstruction is unacceptable — high-traffic corridors where lane closures for 2–3 weeks of reconstruction are operationally too costly.
5. Budget for full reconstruction is unavailable — DBR costs roughly 25–35% of full reconstruction, making it a viable option when full replacement is not budgeted.
DBR Is NOT Appropriate When:
1. Slabs are extensively cracked — multiple structural cracks in slabs indicate the concrete itself is failing, not just the joints.
2. Faulting exceeds 10mm or is accompanied by pumping — indicates subbase failure that DBR cannot address.
3. Pavement is near end of structural service life — adding 15-year dowels to pavement with 5 remaining years of structural life is uneconomic.
4. Joints are spalled or deteriorated beyond repair — DBR cannot rebuild damaged joint edges, and won't perform well in compromised concrete around the joint.
The DBR Process: Step-by-Step
A complete DBR installation consists of seven phases:
Phase 1: Pavement Investigation and Design
Before DBR begins, the project engineer assesses:
Current load transfer efficiency (LTE) at affected joints
Joint faulting measurements
Concrete strength and condition around joints
Underlying subbase condition
Total pavement service life remaining
Based on this assessment, the DBR design specifies:
Dowel diameter and length (typically matching new construction specs)
Number of dowels per joint
Slot dimensions
Backfill material specification (rapid-setting concrete or polymer composite)
Phase 2: Traffic Control and Site Setup
DBR requires lane closure of the affected pavement section. Traffic control includes:
Lane closure signage and barriers
Traffic detours or contraflow on adjacent lanes
Worker safety perimeter
Most DBR projects are scheduled during off-peak hours (nights, weekends) to minimize traffic disruption. Many projects use rapid-setting concrete that allows lanes to be reopened within 4–8 hours of completion.
Phase 3: Slot Cutting
The most critical phase. Slots are cut into the pavement surface using a specialized slot cutter — typically a multi-blade saw on a wheeled chassis that cuts multiple slots simultaneously across the joint.
Standard slot dimensions:
Parameter | Specification |
|---|---|
Slot length | 900mm (36 inches) — extends 450mm on each side of the joint |
Slot width | 75–100mm (3–4 inches) — wide enough for dowel placement plus epoxy/grout |
Slot depth | T/2 + 12mm — slot bottom is at slab mid-depth |
Slot spacing | 300mm c/c — same as new construction dowel spacing |
Slots per lane | 11–12 (matching dowel count for 3.5m lane) |
Slot orientation | Perpendicular to joint, parallel to direction of traffic |
The slot length (900mm) is twice the dowel length (450mm) — providing 450mm of cured concrete on each side of the joint for the dowel to embed in. This is critical because the dowel needs full 225mm embedment on each side of the joint to function properly.
Phase 4: Slot Cleaning
After slot cutting, every slot must be thoroughly cleaned:
Remove debris — concrete fragments, dust, and slurry from saw cutting
Sandblast or pressure wash — clean concrete surfaces in the slot
Compressed air blast — remove any residual moisture and dust
Verify clean — slot surfaces should be dry and free of contamination
Clean slots are essential because the rapid-setting concrete or polymer backfill needs a clean concrete surface to develop full bond. Contamination reduces bond strength and accelerates failure.
Phase 5: Dowel Bar Placement
The dowel bars are placed in the cleaned slots:
1. Position chairs Plastic chair supports are placed at the bottom of each slot, holding the dowel bar at the correct depth (slab mid-depth) within the slot. Chairs typically have a clip mechanism that engages the bar.
2. Place dowel bar The dowel bar is placed horizontally on the chair, centered on the joint. The bar should:
Be exactly perpendicular to the joint
Be parallel to the road centerline
Span the joint with equal embedment on each side (225mm typical)
3. Place second chair (optional) A second chair near the other end of the bar provides additional support for the bar to prevent settling during backfill.
4. Apply bond breaker Bond breaker is applied to one half of the bar — typically grease or specific bond-breaker compound. The bond breaker direction must match the project specification.
5. Caulk or seal joint The joint itself is caulked with a flexible material (silicone or polyurethane) to prevent the rapid-setting concrete from flowing into the existing joint.
Phase 6: Backfill Placement
The slots are filled with rapid-setting concrete or polymer composite:
Rapid-setting concrete options:
Calcium aluminate cement — sets in 1–4 hours at 20°C
Magnesium phosphate cement — sets in 30 minutes to 2 hours
Polymer-modified concrete — sets in 2–4 hours
Proprietary rapid-setting blends — various formulations
The backfill is mixed on site or in a mobile mixer, poured into the slots, and consolidated with vibrators or hand tools. The mix design provides:
High early strength (suitable for traffic in 2–8 hours)
Bond to existing concrete
Compatibility with the dowel bar coating
Resistance to shrinkage cracking
The backfill is finished flush with the surrounding pavement surface — overfill is removed; underfill (settling) is corrected with additional material.
Phase 7: Joint Restoration and Surface Finishing
After backfill cures sufficiently:
1. Remove caulk from joint The joint caulking is removed to allow the joint to function (open and close with thermal cycling).
2. Saw-cut joint reservoir (if needed) Some projects re-saw the joint to clean the joint reservoir.
3. Re-seal joint The joint is sealed with appropriate sealant for long-term performance.
4. Surface restoration Diamond grinding or other surface treatment may be applied if surface profile or smoothness requires correction.
5. Open to traffic Once the backfill has reached design strength (2–8 hours typically), the lane reopens to traffic.
The complete DBR cycle from lane closure to lane reopening is typically 4–8 hours for a 200m section, depending on the number of joints, weather conditions, and rapid-setting concrete formulation.
DBR Slot Geometry: Why Dimensions Matter
The slot geometry directly affects DBR performance:
Slot Length (900mm)
The slot must be long enough that the dowel bar has 225mm of embedment on each side of the joint. Shorter slots reduce the bond length and compromise load transfer. Longer slots are wasteful and reduce slab integrity. The 900mm length comes from FHWA research showing this is the minimum length that provides full structural performance.
Slot Width (75–100mm)
Width must accommodate the dowel bar (32mm + chair clearance), tools for slot preparation and bar placement, and adequate space for backfill flow around the bar. Wider slots are easier to work in but require more concrete backfill. Narrower slots are economical but make placement difficult. The 75–100mm width is the practical compromise.
Slot Depth (T/2 + 12mm)
The slot bottom must be deep enough to position the dowel at slab mid-depth, with some clearance for the chair. For a 200mm slab, slot depth = 200/2 + 12 = 112mm. Slots that are too deep weaken the existing slab. Slots that are too shallow position the bar incorrectly.
Slot Spacing (300mm c/c)
Standard 300mm spacing matches new construction dowel spacing. The total slots per joint = (lane width / 300) + 1 = approximately 11 slots for a 3.5m lane. For airport runways and heavy industrial applications, tighter 230mm spacing is sometimes specified, requiring 14–15 slots per joint.
Dowel Bar Specifications for DBR
Dowel bars used in DBR installations are typically the same specification as new construction:
Parameter | Standard DBR Specification |
|---|---|
Standard | ASTM A1078 / ASTM A615 Grade 60 |
Diameter | 32mm (1-1/4") for 200mm slabs; 38mm (1-1/2") for 250mm+ slabs |
Length | 450mm (18 inches) standard |
Coating | Fusion-bonded epoxy per ASTM A775; minimum 8 mil thickness |
End preparation | Saw-cut square ends with epoxy patch repair |
Bond breaker | Pre-applied or applied on site |
Surface condition | Clean, no oil/grease/contamination |
Some DBR projects specify slightly different dowel dimensions:
Slightly smaller diameter (32mm even for thicker slabs) to reduce slot width and concrete volume
Slightly shorter length (400mm instead of 450mm) to reduce slot length and total backfill volume
These variations are project-specific and should be confirmed with the project engineer.
Materials Required Per DBR Joint
For a typical 11-dowel DBR joint:
Item | Quantity per Joint |
|---|---|
Dowel bars (32mm × 450mm) | 11 |
Plastic chairs | 22 (2 per dowel) |
Bond breaker compound | ~250g |
Joint caulking | ~3m |
Rapid-setting concrete | ~50–80 liters |
Joint sealant | ~1–2 liters |
For a 1km project with 220 joints (4.5m joint spacing), total material requirement:
Item | Total Quantity |
|---|---|
Dowel bars | ~2,420 |
Chairs | ~4,840 |
Bond breaker | ~55 kg |
Joint caulking | ~660m |
Rapid-setting concrete | ~12–18 cubic meters |
Joint sealant | ~220–440 liters |
These quantities form the basis of project material take-offs and procurement requirements.
DBR Cost Comparison
DBR is typically 25–35% the cost of full pavement reconstruction:
Activity | Relative Cost |
|---|---|
Full pavement reconstruction (1 km) | 100% (baseline) |
DBR + diamond grinding (1 km) | 25–35% |
DBR alone (no grinding) (1 km) | 18–25% |
Joint sealing alone (1 km) | 5–8% |
Diamond grinding alone (1 km) | 12–18% |
For DOTs and highway authorities, DBR offers significant value:
Extends pavement life 15–25 years
Avoids the disruption of full reconstruction
Defers full reconstruction cost to a later budget cycle
Maintains pavement smoothness and ride quality
The economics improve further when traffic disruption costs are included. Full reconstruction may close lanes for 2–3 weeks per kilometer; DBR closes lanes for 4–8 hours per section. For a busy highway, the operational cost difference can be substantial.
DBR vs Other Rehabilitation Options
DBR is one of several pavement rehabilitation techniques. Project engineers compare options based on the specific failure mode:
DBR vs Diamond Grinding
Diamond grinding removes a thin layer of concrete from the pavement surface, restoring smoothness and texture. It addresses ride quality issues but does NOT address joint load transfer.
DBR addresses joint load transfer but does NOT improve surface texture or smoothness.
Both are often combined in one rehabilitation project: DBR to restore load transfer + diamond grinding to restore surface profile = comprehensive joint and surface rehabilitation.
DBR vs Joint Sealing
Joint sealing replaces deteriorated joint sealant to keep water out of joints. It addresses water infiltration but does NOT address load transfer or faulting.
DBR addresses faulting and load transfer but does NOT replace joint sealant.
Both are often combined: DBR + joint sealing = restored joint load transfer + watertight joints.
DBR vs Slab Replacement
Slab replacement removes and replaces individual deteriorated slabs. It addresses severely cracked or damaged slabs but is highly disruptive and costly per slab.
DBR addresses joint performance issues across many joints simultaneously without slab removal.
Project decision: For pavements with many degraded joints but sound slabs, DBR is far more economical than replacing slabs. For pavements with widespread slab cracking, slab replacement is required (DBR cannot fix broken slabs).
DBR vs Asphalt Overlay
Asphalt overlay places asphalt concrete over existing concrete pavement. It addresses smoothness and surface texture but transfers all load through the existing slab.
DBR restores joint performance in the underlying concrete but doesn't address surface conditions.
Project decision: Asphalt overlay is sometimes used on heavily deteriorated pavement where joint performance is irrelevant. DBR is used when restoring joint performance is the primary objective and concrete pavement integrity must be maintained.
Real-World DBR Performance
FHWA-funded studies have tracked DBR performance over 10–25 years on actual highway projects:
Joint Load Transfer Efficiency (LTE):
Pre-DBR: 30–50% LTE on degraded joints
Post-DBR: 75–85% LTE
After 15 years: 65–75% LTE (some degradation but still functional)
After 25 years: 55–70% LTE (approaching threshold for further intervention)
Joint Faulting Reduction:
Pre-DBR: 5–10mm typical
Post-DBR: 1–2mm
After 15 years: 2–4mm (gradual increase)
After 25 years: 3–6mm (re-approaching pre-DBR levels)
Pavement Service Life Extension:
Without DBR: pavement reaches end of service in 5–10 years from typical degraded state
With DBR: pavement extends 15–25 additional years before full reconstruction needed
Total economic value: 50%+ extension of total pavement service life
These performance results justify DBR as a primary highway rehabilitation tool used by DOTs in the US, motorway authorities in Europe, and highway agencies globally.
Quality Control for DBR Projects
DBR quality control requires verification of multiple variables:
Material Quality
Dowel bars per ASTM A1078 / A615 Grade 60
Coating thickness and integrity per ASTM A775
Rapid-setting concrete strength testing
Bond breaker compound certification
Slot Geometry
Slot length (900mm typical)
Slot width (75–100mm)
Slot depth (T/2 + 12mm)
Slot spacing and quantity per joint
Slot Preparation
Cleanliness verification
Moisture verification (slots should be dry before backfill)
Dowel Placement
Correct bar size and length
Correct bar orientation (perpendicular to joint, parallel to road)
Bond breaker correctly applied
Chairs positioned correctly
Backfill Placement
Concrete consolidated and finished flush
Cure time before traffic
Strength verification (typically 25 MPa minimum at traffic opening)
Post-Installation Testing
Visual inspection
MIT-DOWEL-SCAN testing of random joints (per ASTM E3013)
Load transfer efficiency testing (FWD — Falling Weight Deflectometer)
For complete coverage of installation quality control, see the Dowel Bar Installation Guide.
Common DBR Installation Errors
After 15+ years supplying dowel bars to highway and pavement projects (including many DBR retrofits), these are the errors that compromise DBR performance:
Error 1: Slot Not Cleaned Properly
Symptom: Backfill bond failure within 1–2 years; backfill spalls out of slot
Cause: Concrete dust, slurry, or moisture left in the slot before backfill placement
Prevention: Sandblast and pressure wash slots; verify dry surface before backfill
Error 2: Wrong Slot Dimensions
Symptom: Dowels at wrong depth; bond length insufficient; load transfer compromised
Cause: Slot cutter not properly calibrated; slot dimensions not verified during cutting
Prevention: Calibrate cutter for project-specific slab thickness; measure slot dimensions on first installation; verify at random checkpoints
Error 3: Dowels Not Positioned Correctly in Slot
Symptom: Dowels at angles to joint, at wrong depth, or with unequal embedment on each side
Cause: Chairs not properly positioned; dowels not centered on joint; bond breaker direction wrong
Prevention: Use proper chairs; verify dowel position before backfill; verify bond breaker direction
Error 4: Backfill Cure Time Insufficient
Symptom: Backfill cracks shortly after traffic opens; pop-outs at slot edges
Cause: Lane reopened before backfill reaches design strength
Prevention: Test backfill strength before opening lane; follow manufacturer cure time recommendations; consider slower-setting backfill for longer-cure conditions
Error 5: Dowel Bar Coating Damaged During Placement
Symptom: Coating defects accelerate corrosion at slot location; future spalling
Cause: Bar dropped, scraped, or impacted during placement; chairs damage coating
Prevention: Handle bars carefully; use plastic chairs (not metal that scratches coating); verify coating before placement
Supply from Kasko Makine
Kasko Makine supplies dowel bars and DBR materials for pavement rehabilitation projects:
Dowel bars for DBR: Same specifications as new construction dowels — fusion-bonded epoxy coated per ASTM A1078, A615 Grade 60 base steel, diameters 25–40mm, lengths 350–500mm. For complete coating selection guidance, see Epoxy vs Galvanized vs Stainless vs FRP.
Plastic chairs: Compatible with all dowel diameters, designed to position bars at correct depth within slots. Standard supply with dowel bar orders.
Bond breaker: Pre-applied bond breaker (factory-applied to half of each bar) or separate bond breaker compound for on-site application.
Standard DBR project package:
Dowel bars (typically 32mm × 450mm or 38mm × 450mm)
Plastic chairs (2 per dowel)
Bond breaker (pre-applied or compound)
Anchor pins (if needed for chair positioning)
Documentation: EN 10204 Type 3.1 MTC, coating certification, dimensional reports
We do NOT supply rapid-setting concrete or epoxy backfill (these are typically sourced locally to minimize transport cost and ensure freshness). However, we can recommend product specifications and provide guidance on backfill compatibility with our dowel bars.
Technical support: Our engineering team can review DBR project specifications, recommend appropriate dowel bar size and coating for the existing pavement condition, and provide guidance on slot dimensions and material quantities.
Documentation per shipment:
Mill test certificates (EN 10204 Type 3.1)
Coating certifications (ASTM A1078)
Holiday testing results (ASTM G62)
Dimensional verification
Third-party inspection (Bureau Veritas, SGS, TÜV) available on request
Logistics: DBR projects often require fast delivery to maintain construction schedule. We maintain stock of common dowel bar sizes (32mm × 450mm and 38mm × 450mm in epoxy coating) for rapid shipment. Custom sizes typically deliver within 4–6 weeks.
Request DBR materials pricing — send us your project details (slab thickness, total joints to retrofit, dowel bar specification, packaging requirements, and delivery location) to info@kaskomakine.com or WhatsApp +90 (537) 521 1399. We respond within 24 hours with a complete quotation and delivery schedule for projects across Africa, the Middle East, Central Asia, and beyond.
Continue Reading: Complete Dowel Bar Series
This DBR guide is part of our comprehensive dowel bar guide series:
Dowel Bars: The Complete Guide — The master pillar covering specifications, sizes, materials, and selection
Dowel Bar vs Tie Bar: 8 Differences — Critical comparison preventing pavement specification mistakes
Dowel Bar Sizes & Diameter Chart — Comprehensive sizing reference for every slab thickness
Epoxy Coated Dowel Bars: ASTM A1078 — The global standard coating in detail
Epoxy vs Galvanized vs Stainless vs FRP — Coating comparison with cost analysis
Dowel Baskets: Types & Installation — Basket assemblies and pre-pour quality control
Dowel Bar Installation Guide — Methods, tolerances, and best practices
Dowel Bar Load Transfer Engineering — Friberg's analysis and LTE calculations
Dowel Bar Supplier & Procurement Guide — How to source dowel bars correctly
FAQ SCHEMA
Q: What is dowel bar retrofit (DBR)?
A: Dowel bar retrofit is a pavement rehabilitation technique that adds dowel bars to existing concrete pavement joints that were originally constructed without dowels (or with damaged dowels). The dowels are placed in saw-cut slots in the pavement surface, oriented to span across the joint, and backfilled with rapid-setting concrete. DBR restores joint load transfer efficiency, prevents further joint faulting, and extends pavement service life by 15–25 years at roughly 25–35% the cost of full pavement reconstruction.
Q: When is DBR appropriate?
A: DBR is appropriate when: (1) existing slabs are structurally sound (no extensive cracking), (2) joint faulting is moderate (3–8mm), (3) pavement has at least 15+ years of expected remaining service life, (4) traffic disruption from full reconstruction would be operationally too costly, and (5) budget is constrained. DBR is NOT appropriate when slabs are extensively cracked, faulting exceeds 10mm with pumping, the pavement is near end of service life, or joints are spalled beyond repair.
Q: How big are the slots cut for DBR?
A: Standard DBR slot dimensions are 900mm long (extending 450mm on each side of the joint), 75–100mm wide, and at depth of T/2 + 12mm (slot bottom at slab mid-depth plus chair clearance). For a 200mm slab, slot depth is 112mm. Slot spacing matches new construction dowel spacing — 300mm center-to-center, with 11–12 slots per 3.5m lane.
Q: What is the cost of DBR compared to full pavement reconstruction?
A: DBR typically costs 25–35% of full pavement reconstruction. The cost savings are even greater when traffic disruption costs are included — DBR closes lanes for 4–8 hours per section, while full reconstruction closes lanes for 2–3 weeks per kilometer. For DOTs and highway authorities, DBR offers significant value by extending pavement life 15–25 years and deferring full reconstruction costs to a later budget cycle.
Q: How long does DBR take to install?
A: A typical DBR installation cycle from lane closure to lane reopening is 4–8 hours for a 200m section, depending on the number of joints, weather conditions, and rapid-setting concrete formulation. Most DBR projects use rapid-setting concrete (calcium aluminate, magnesium phosphate, or proprietary blends) that allows lanes to reopen within 2–8 hours of completion.
Q: How long does DBR last?
A: FHWA-funded studies show DBR-restored joints maintain 75–85% load transfer efficiency immediately after retrofit, gradually degrading to 65–75% after 15 years and 55–70% after 25 years. Joint faulting reduction is similar — 1–2mm immediately after DBR, 2–4mm after 15 years, 3–6mm after 25 years. The total pavement service life extension is typically 15–25 years.
Q: What dowel bar specification is used for DBR?
A: DBR projects typically use the same dowel bar specification as new construction — ASTM A1078 / ASTM A615 Grade 60 fusion-bonded epoxy coated, 32mm or 38mm diameter, 450mm length. Some projects specify slightly smaller diameter (32mm even for thicker slabs) to reduce slot width and concrete volume. Always confirm the specific dowel specification with the project engineer before procurement.
Need industrial materials for your project?
600+ certified products — valves, pipes, fittings, flanges & more. Get a detailed quote from our engineering team within 24 hours.
